Luther Burbank South Shoreline Restoration

Project ID:
(PA0136)
Project Type:
Parks
Project Status:
Planning/Design
Location:

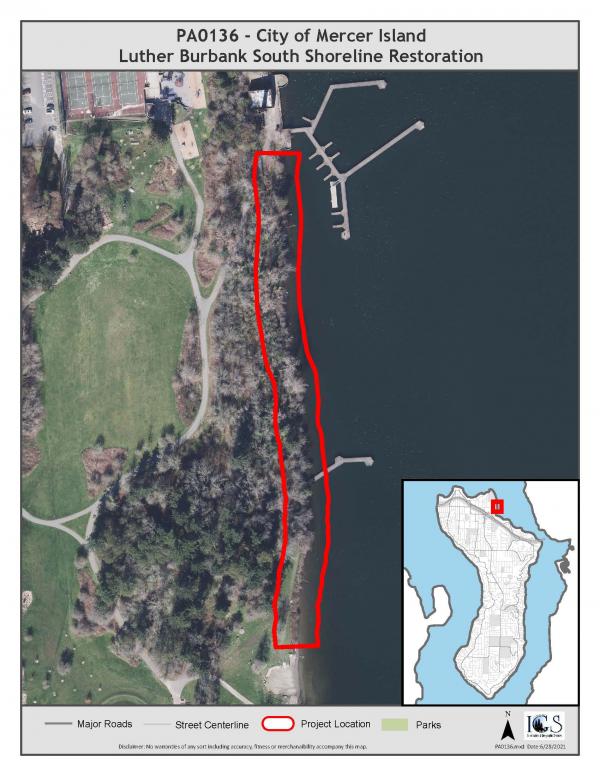

Luther Burbank Park

project location

Project Status

To help keep area residents informed of our construction progress, we will post project updates to this site on a regular basis. Click here to see status updates.



Project Details/Neighborhood

  • 900 feet of shoreline from the waterfront plaza to the swim beach

​Background

The shoreline at Luther Burbank Park has been slowly eroding for the past 110 years as a result of the lowering of Lake Washington. Changes in boat traffic over the past 50 years have accelerated this process. Previous phases of shoreline restoration have been completed on the north section (waterfront plaza through the off-leash area) and at Calkins Point. The shoreline has eroded to an extent that it is undermining the existing shoreline trail and has caused the trail to collapse in more than one location.

Description

This project covers approximately 900 feet of shoreline from the waterfront plaza to the swim beach. Restoration work includes anchoring large woody debris, adding rock spawing gravel, invasive plant control, plantings including brush layering, and temporary irrigation (which will be repurposed to irrigate the swim beach with lake water). The project also includes relocating the shoreline trail away from the eroding shoreline and constructing it with ADA accessible grades and surfacing.

Project Timeline (Target Completion Date)

Q4 2023

Estimated Budget

2021 $47,000

2022 $660,000

Contact

Paul West, City of Mercer Island Project Manager: (206)275-7833 or paul.west@mercerisland.gov

public information signs are up
Status Updates

October 2022 Update

Key staff moved into new positions, halting construction. Erosion control and site clearing were completed. The remaining construction has been postponed until April 2023. Certain trail elements that expected to construct with volunteer or conservation corps have been combined into a bid package that will be released this fall. Erosion control and vegetation work will continue this fall.

May 2022 Update

public information signs

Photo: public information signs are up

Construction will start in May and run through November 2023. The trail will be closed for part of this time.

February 2022 Update

Staff submitted a geotechnical report for land use review in December. Geotechnical review happened in late January and land use permitting will continue through March. Staff continues to work with the consultant, Anchor QEA, to finalize project designs. The staff has also learned that the City’s Public Works Natural Resources Unit is expecting to hire four seasonal employees to provide the main workforce for this summer’s construction.

November 2021 Update

Land Use permitting is underway. Two King County Waterworks grants were awarded. All grant funding totals $225k for this project. Work plan development for trail construction in 2022 will include Mountains to Sound Greenway volunteers, summer crews, and conservation corps.
