Reservoir Standby Generator Replacement

Project ID:
22-25 (WU0119)
Project Type:
Water
Project Status:
Under Construction

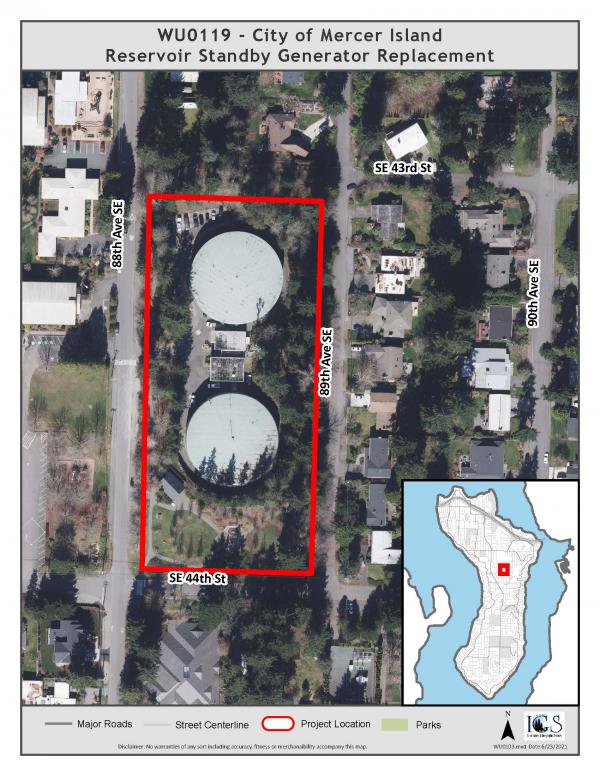

Project Location​​Project Status

Click here to see status updates

Project Details/Neighborhood

  •  Various locations on Mercer Island

​Background

A water system must have sufficient capacity to supply water at proper pressure throughout the distribution system. The majority (75%) of the City’s water system relies on 5 booster pumps, located at the reservoir, for maintaining this pressure. In the event of a power outage, the reservoir’s generator must provide enough power to operate the booster pump station and provide backup power to the emergency well. The existing generator is approaching the end of its useful life and the availability of spare parts is limited.

Description

This project will replace the existing generator, currently located inside the reservoir booster pump station, and relocate the generator outside the building in a self-contained enclosure. This new configuration will provide more efficient operations and reduce noise output when the system is running.

Project Timeline

Design 2021-2022
Construction 2023-2024


Contact

George Fletcher, City of Mercer Island Project Manager:  george.fletcher@mercerisland.gov
https://www.mercerisland.gov/WU0119


Status Updates

April 19, 2024

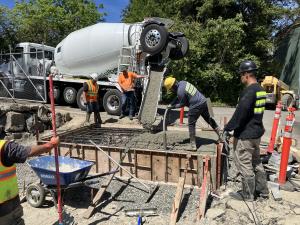

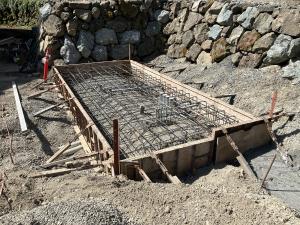

The rockery relocation is now complete; concrete formwork was completed yesterday for the new fuel tank, load bank, and generator concrete pads. The next steps include subgrade, forms, and rebar inspections followed by Dalton Electric installing conduit stubs before pouring concrete.

January 25, 2024

This project had been on hold due to a grade conflict with the underground power feed into the reservoir site. PSE crews were on site the week of January 15th to lower their conduit and replace old wiring. This work required a planned power outage for the reservoir site and back-up generator power was used for that day. The City’s contractor, McClure and Sons, will now be able to complete their grading and concrete pad construction for the new generator. Project completion is anticipated in June 2024.

December 2023

This project is currently on hold  pending PSE crews lowering their power conduit that is currently in conflict with the designed rock wall. Once this is performed, McClure and Sons will return to complete the rockery, pour the concrete pads, and install new electrical conduits from the generator pad to the reservoir building.

September 5th 2023

The contractor McClure and Son’s and their sub, Dalton Electric, will perform conduit relocation for the City’s emergency well power and communications line. This requires the emergency well to be disconnected on Wednesday and restored within the same day. They will be working within the reservoir property and there will be no traffic impacts.

July 2023

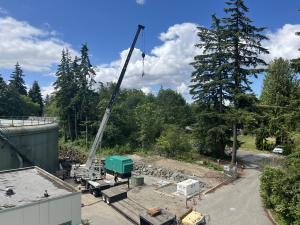

Notice to Proceed for the contractor, McClure and Sons is scheduled for July 19, 2023. Initial work on-site incudes some tree removal, clearing/grading, and rockery work to make room for the generator and related equipment.  Trees will be replaced on-site following the completion of the construction.

February 2023

The construction contract was awarded to McClure and Sons Inc. at the November 15, 2022, City Council meeting. There are long lead times on items such as the diesel generator, transfer switches, and electrical components. Construction is expected to begin in August 2023.

October 2022

Construction bids for this project were due on October 20th.  Staff received five contractor bids, and two bids are below the $1,245,000.00 engineer’s estimate.  The award of a construction contract is scheduled for the November 15th Council meeting, with construction occurring in 2023.

April 2022

In March, the City received the updated plans and specifications from the design consultant, Murraysmith.

February 2022

The City’s consultant, Murraysmith, has been in contact with the generator manufacturer and was informed that industry lead times look to be at least 40 weeks for a generator of this size. City staff met with the consultant to discuss options and will look into pre-purchasing the equipment ahead of construction.

November 2021

The City has decided to add another component to this reservoir generator design which will allow for a direct hookup during annual load bank tests. Work on this is anticipated to start later in November.

September 2021
In June, the city’s consultant Murraysmith provided the 100% design plans and specifications. City staff are working to review these and will reconvene later this fall to determine when to advertise the project for construction bids.
