West Mercer Way Roadside Shoulder Improvements Phase 4

Project ID:
SP0114
Project Type:
Street
Project Status:
Under Construction

project location​​Project Status

To help keep area residents informed of our construction progress, we will post project updates to this site on a regular basis. Click here to see status updates.

Project Details/Neighborhood

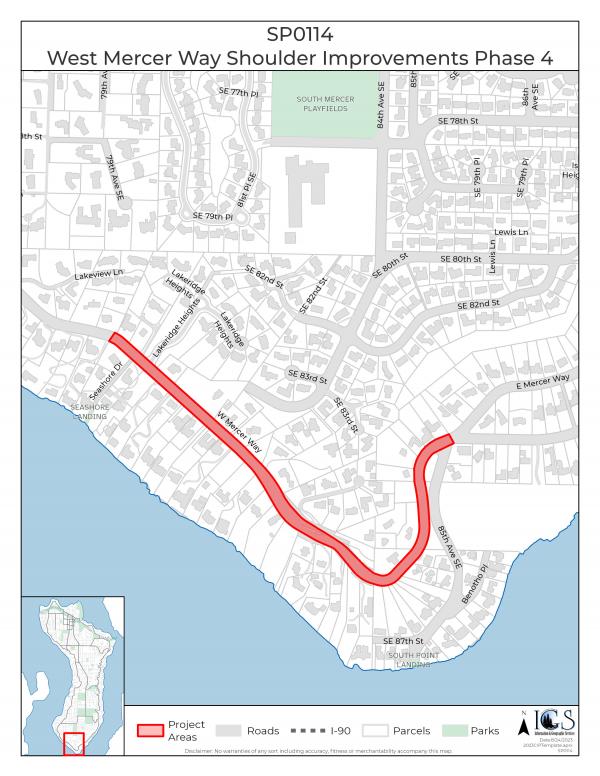

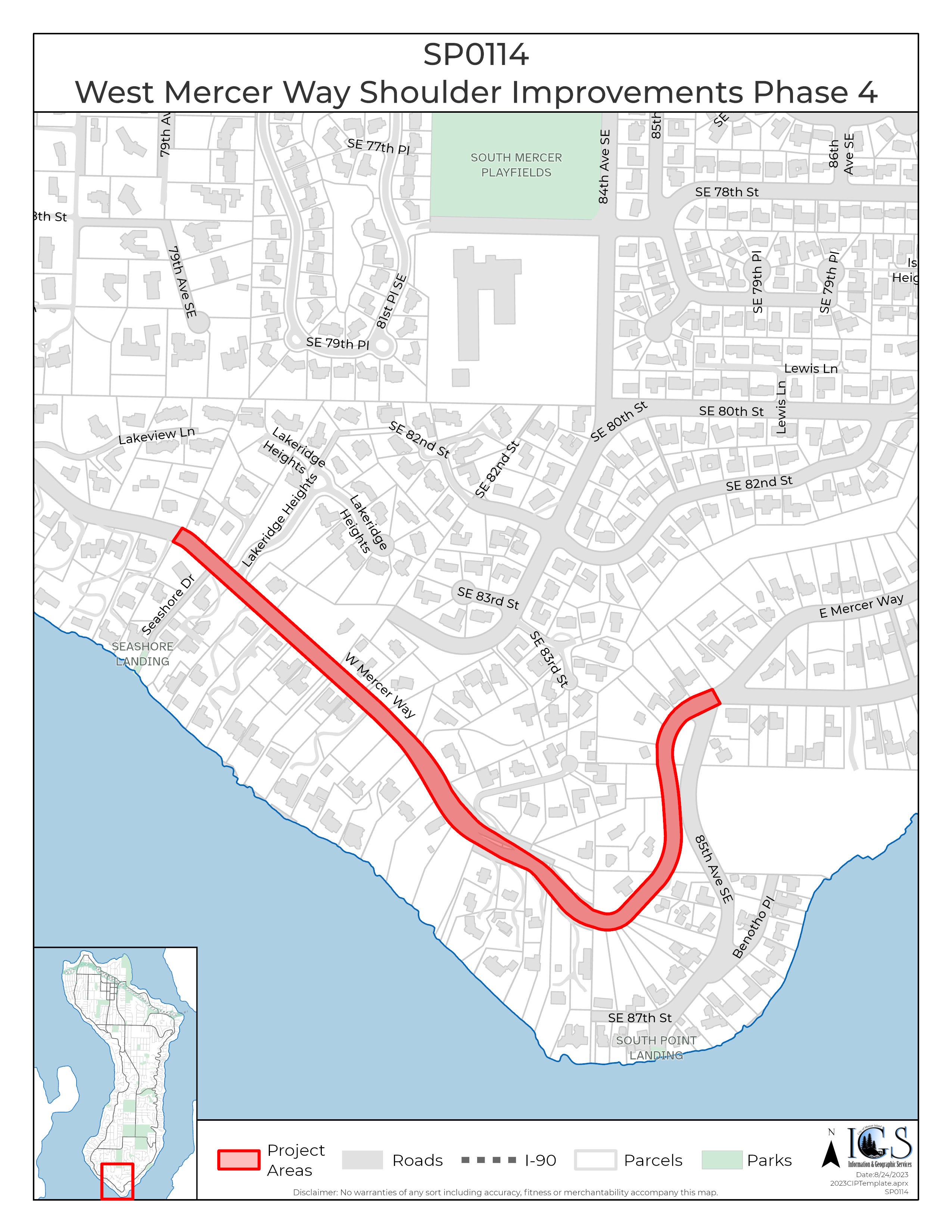

  • West Mercer Way from 8100 West Mercer Way to 8400 East Mercer Way

​Background

The Roadside Shoulder Development Program was established in 2002 to create paved shoulders suitable for pedestrian and bicycle uses on the Mercer Ways. Since then, the City of Mercer Island has constructed numerous shoulder improvement projects, primarily along East Mercer Way, but also along North and West Mercer Ways. Most recently the West Mercer Way Phase 3 Shoulder Improvements (from SE 65th Street to SE 70th Street) project was completed in 2022.

Description

This project will build a new paved shoulder from the 8100 block of West Mercer Way around the south tip of the island to the 8400 block of East Mercer Way. Construction is planned for 2024. This is the final phase of the West Mercer Way shoulder development. This will connect the shoulder on the east side of West Mercer Way from the south end of the island all the way to I-90.

Project Timeline

Planning/Design (Q3 to Q4 2023)

Under Construction (Q1 to Q2 2024)

Completed (Q3 2024)

Estimated Budget

$779,000

Contact

Ian Powell, Street Engineer  ian.powell@mercerisland.gov 206-275-7813

www.mercerisland.gov/SP0114






WMW Phase 4 Grading
Hydrant
wet tapping
Status Updates

April 4, 2024 (Thursday)

A water main shutdown is scheduled for Today April 4th . Residents in affected neighborhoods (8487 West Mercer Way to 8395 East Mercer Way) have received project notification. Copies of the notification can be viewed here

April 2, 2024 (Tuesday)

A water main shutdown is scheduled for Today April 2nd. Residents in affected neighborhoods (8192 West Mercer Way to 8405 West Mercer Way) have received project notification. Copies of the notification can be viewed here

March 22, 2024

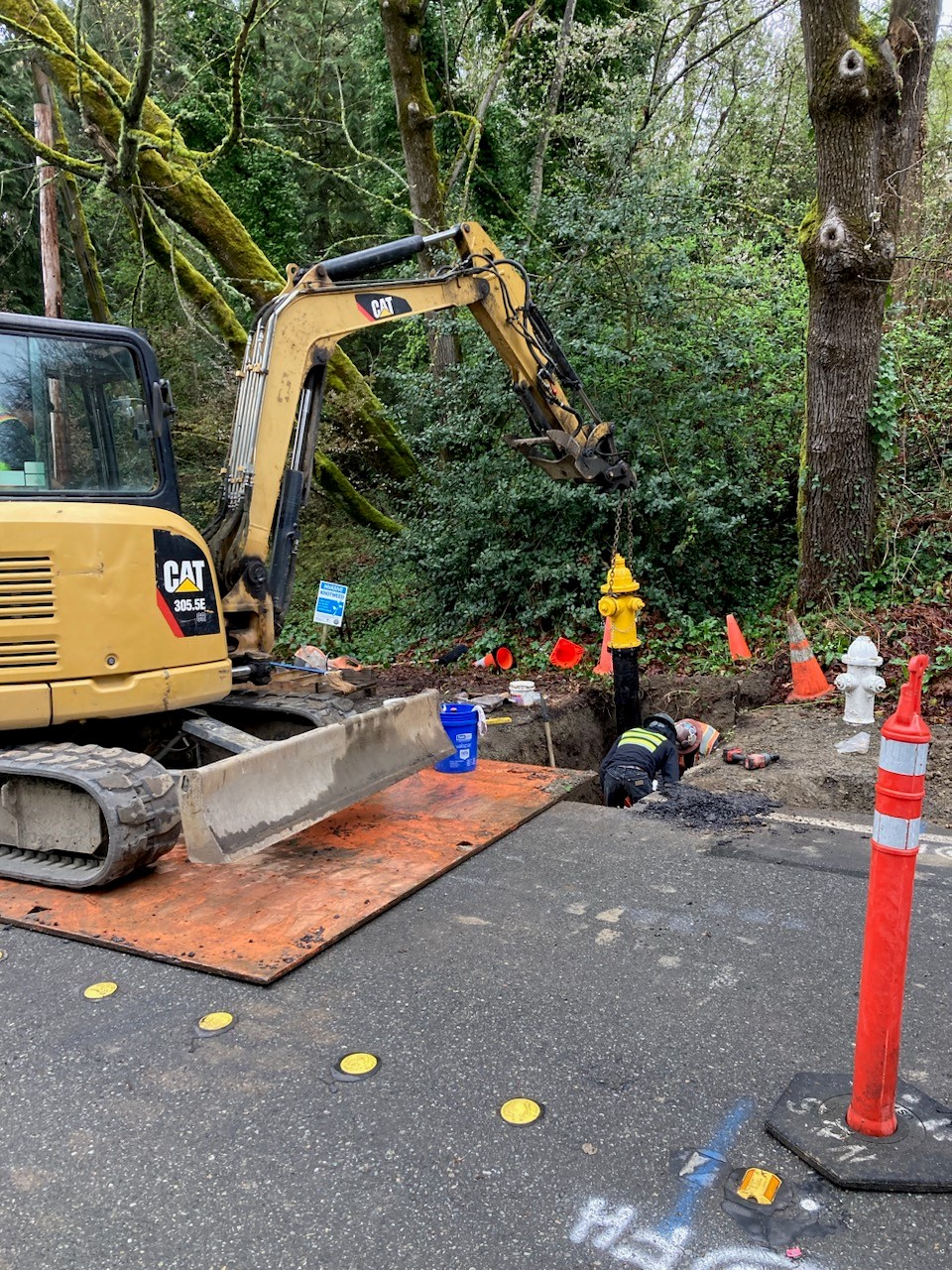

Hydrant Install     Wet Tapping

Photo 1: Hydrant Install

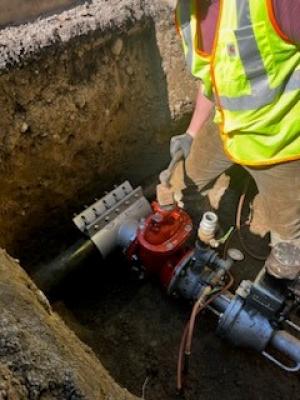

Photo 2: Wet Tapping existing water main to install a new hydrant

This week the city’s contractor, New X, completed four new watermain taps for replacement of four fire hydrants and installed two of those hydrants. The “wet tapping” process allows connection of a new pipe onto a live watermain. Next week, the contractor has a watermain shutdown scheduled to remove an old fire hydrant and replace several water services. This water utility work is necessary to relocate several hydrants and water meters to be outside of the new paved shoulder.

March 15, 2024

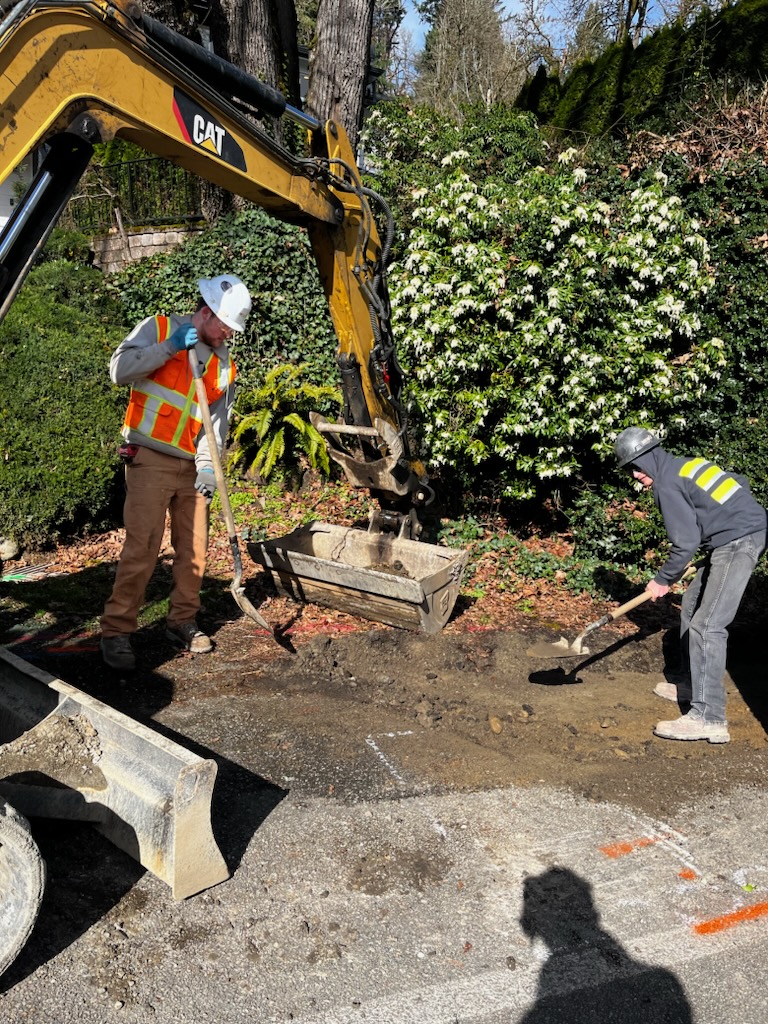

WMW Phase 4 grading
Photo: WMW Phase 4 grading
The City’s contractor has been busy clearing, excavating, and grading for the new shoulder areas. Over the next two weeks, crews will be doing three watermain shutdowns to replace/relocate four fire hydrants and four water services that are in conflict with the new shoulder. This project is scheduled to be complete by June.

February 26, 2024
Construction activity began this week at the East Mercer Way end of the project. The contractor will have more resources arriving next week and will continue installing storm drainage improvements.

February 20, 2024
Nex X Construction will begin shoulder widening improvements along the Mercer Ways from 8100 West Mercer Way to 8400 East Mercer Way. Construction crews will be working between the hours of 7:00 AM and 5:00 PM Monday through Friday, during this time flaggers will maintain one-way alternating traffic. The project is scheduled to be complete by June. Please expect some travel delays in these areas as well as some heavy equipment and truck traffic.

February 9, 2024
Construction activities on this project are scheduled to begin the week of February 20 and work is anticipated to be completed by June 2024. The scope of the project includes installing storm drainage and catch basins, relocating several water meters and fire hydrants to outside the new shoulder area, and grading and paving to create over 2,700 linear feet of new 5-foot wide asphalt shoulder. Crews will be working between 7:00 AM and 5:00 PM, Monday through Friday. During these hours, please expect minor traffic delays on the Mercer Ways between 8100 WMW and 8400 EMW, as the roadway will be reduced to one open lane with traffic being directed by flaggers. A notification letter was sent in late January to residents in the vicinity of the project. You can view the letter here.

February 2024
A construction contract was awarded to New X, Inc. by the City Council on January 16, 2024. Construction activities are tentatively scheduled to begin in the second half of February and the project is anticipated to be complete by June. Construction crews will be working between the hours of 7:00 AM and 5:00 PM, Monday through Friday. During these hours, please expect minor traffic delays on the Mercer Ways within the project area, as the roadway will be reduced to one open lane with traffic being directed by flaggers.

Mailing was sent to residents in the area of the project. You can view the letter here.

December 15, 2023
Project was advertised for bids in early December, and bids are due on December 19th. Link to bid page. Construction is scheduled to begin in Q1 of 2024.
